Streetcar Progress Update: March 2, 2015

Mar 02, 2015

Streetcar Progress Update: March 6, 2015

5th & Walnut Intersection Trackwork Closure Postponed

Weather conditions have postponed trackwork on Walnut Street through the intersection at 5th for a second week. This work was originally scheduled to be performed last weekend, but was rescheduled due to weather.

The work is rescheduled to start Friday, March 6 at 7 p.m.. The 5th and Walnut intersection will close at that time until Monday, March 9 at 6 a.m.

5th Street will be closed at Vine Street.  Eastbound traffic on 5th Street will be detoured north at Vine Street.

Detours will be posted.

Block by Block Construction (March 2-8, 2015)

MAIN STREET

  • 2nd to 3rd: Storm sewer work (2 weeks remaining); Underground electrical work (13 weeks remaining)
  • 3rd to 4th: Underground electrical work (13 weeks remaining)
  • 4th to 5th: Underground electrical work (13 weeks remaining)
  • 5th to 6th: Underground electrical work (13 weeks remaining)
  • 6th to 7th: Water main tie-ins (1 week remaining); underground electrical work (3 weeks remaining)
  • 7th to 8th: Water main tie-ins (1 week remaining); underground electrical work (3 weeks remaining)
  • 8th to 9th: Storm sewer work (1 week remaining); underground electrical work (3 weeks remaining)
  • 9th to Court: Storm sewer work (1 week remaining); OCS foundations (2 weeks remaining); underground conduit work (1 week remaining); underground electrical work (3 weeks remaining)
  • At 12th: Conduit work for traffic signals (2 weeks remaining)

WALNUT STREET

  • At 2nd: Pavement removal (2 weeks remaining)
  • 2nd to 3rd: Pavement removal (2 weeks remaining)
  • 4th to 5th: Conduit work for traffic signals (1 week remaining)
  • 5th to 6th: Track installation (1 week remaining)
  • 9th to Central Parkway: Storm sewer work (1 week remaining); Conduit work for traffic signals (1 week remaining); sitework on Court Street power substation (10 weeks remaining)
  • At Central Parkway: Traffic signal work (2 weeks remaining)

RACE STREET

  • At 13th: Storm sewer work (1 week remaining)
  • 13th to 14th: Storm sewer work (1 week remaining)
  • 14th to 15th: Storm sewer work (1 week remaining)
  • 15th to Liberty: Storm sewer work (1 week remaining)
  • Liberty to Green: Telecomm work (1 week remaining)
  • Sellew Alley to Henry: Telecomm work (1 week remaining)
  • At Henry: Overhead wire installation for power system (2 weeks remaining)

ELM STREET

  • Glass Alley to Henry: Telecomm work (1 week remaining)
  • At Henry: Overhead wire installation for power system (2 weeks remaining)

CENTRAL PARKWAY

  • Race to Vine: Traffic signal work (2 weeks remaining)

12TH STREET

  • Main to Vine: Traffic signal work (1 week remaining)

Progress Last Week:

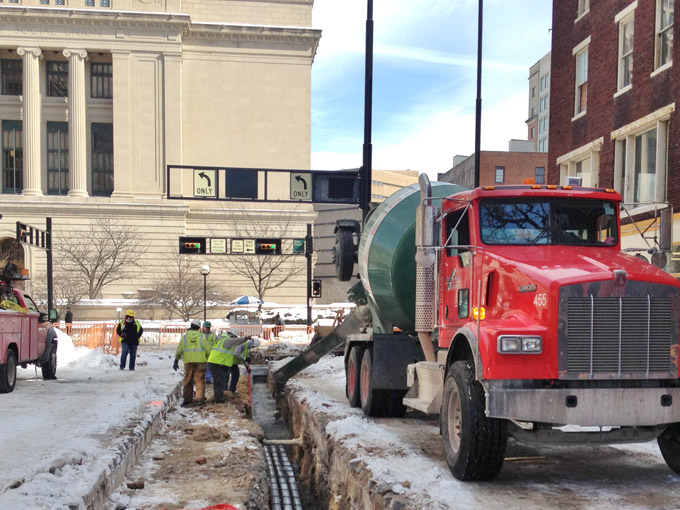

Crews encased the conduit underneath Court Street.

Conduit encasement in concrete

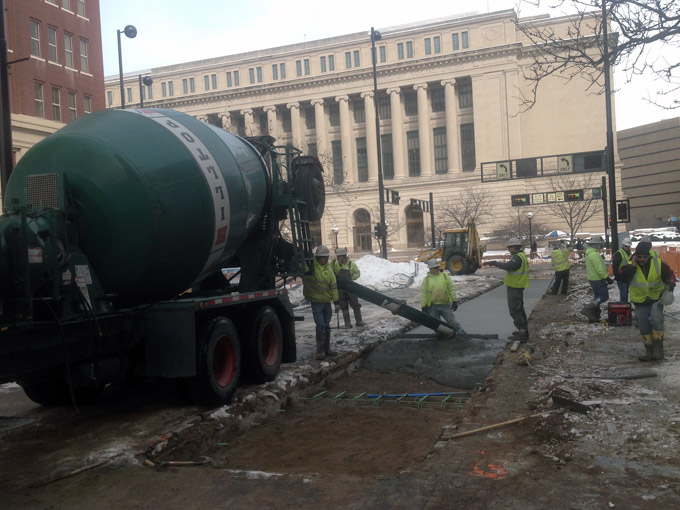

Foundations for the pavers were poured....

Concrete pouring for paver foundations

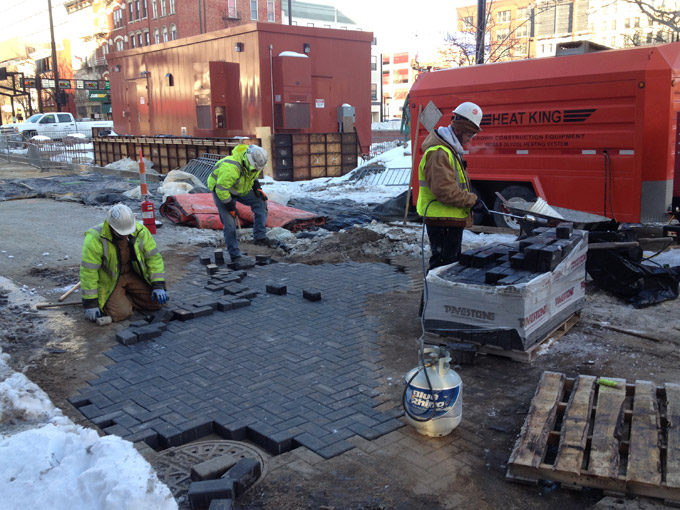

...and the pavers were installed.

Paver installation on Court Street

An old water valve is being replaced on Main Street near Gano Alley.

Old water valve on Main Street

Crews leveled poles for the overhead power system on Henry Street.

Leveling a pole with wrench

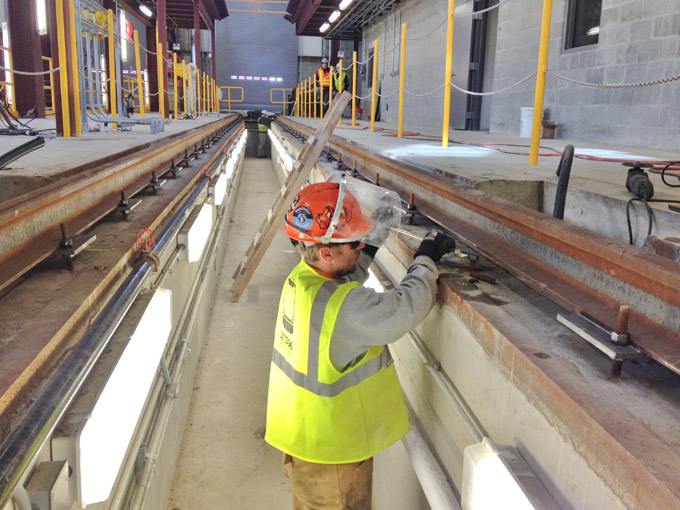

Nearby, at the Maintenance & Operations Facility, rail was installed in the narrow pit.

Installing rail in narrow maintenance pit
